Highway Works Delivery Plan
The delivery of the highway works is carefully planned in stages to minimize disruption while ensuring steady progress. Each stage focuses on preparing, implementing, and completing key infrastructure improvements.
Highway Works Delivery Overview
A comprehensive timeline showing the phased approach to highway improvements.
Our Video
Shows the construction stages in sequence - Coming Soon
Video showing how the construction is planned to fit the local areas adjacent to our new operation programmes.
Planning & Approval Phase
Comprehensive planning applications, community consultation, and regulatory approvals secured.
- • Planning permission granted
- • Environmental impact assessments completed
- • Community engagement sessions held
- • Detailed design development
Preparatory works are being carried out in Station Road
We are working with Cadent Gas who are continuing gas pipeline replacement and are approaching completion.
- • The new traffic lights have been constructed in Station Road and the new footpaths completed
- • Work will continue on completing the new carriageway on Station Road and the associated footway construction
- • Temporary traffic lights will be used at the Cool Oak Lane junction where necessary with the Glenpark Sports Club temporary QMS traffic management system where necessary during the temporary works
The new traffic lights will be switched on and Station Road will open
Major traffic reconfiguration marking the transition to permanent arrangements.
- • Station Road opened between West Hendon Broadway and Wilberforce Road as planned
- • Wilberforce Road and Herbert Road will be reversed
- • Perryfield Way will be permanently closed to through traffic
- • Traffic lights at Perryfield Way and Herbert Road will be removed
Complete the remaining Station Road work and improvements to West Hendon Broadway
Once the construction of the carriageway on Station Road has been completed and the traffic switch has taken place, carriageway construction will commence on the West Hendon Broadway between Cool Oak Lane and Garrick Road.
- • When construction starts, we will adopt a phased approach to allow one line of traffic to pass using alternating lane closures to facilitate the progress and completion of the program
- • Towards the end of the programme and on completion of carriageway construction we will carry out the final carriageway resurfacing during night time working hours to minimise disruption to traffic
Minimizing Disruption
Comprehensive measures to reduce impact on residents and businesses during construction.
- • Advanced warnings of significant disruptions
- • Maintain access for residents and businesses wherever possible
- • Phased approach ensures minimal impact on local community
- • Temporary closures, diversions, and occasional night work as needed
What happens next?
We'll be getting our plans ready with some remaining jobs to be completed by the next operation of the new operating system. These will include:
- • Changes to signing systems for new vehicle facilities
- • Changes to the new road sections of Wilberforce Road and Herbert Road and the Code for the Permanent Stopping Up of Perryfield Way
- • We will also publish the Code for the Permanent Stopping Up of Perryfield Way
Construction Progress Plans
Visual timeline showing how construction phases develop over time. Click any thumbnail to view the full plan.

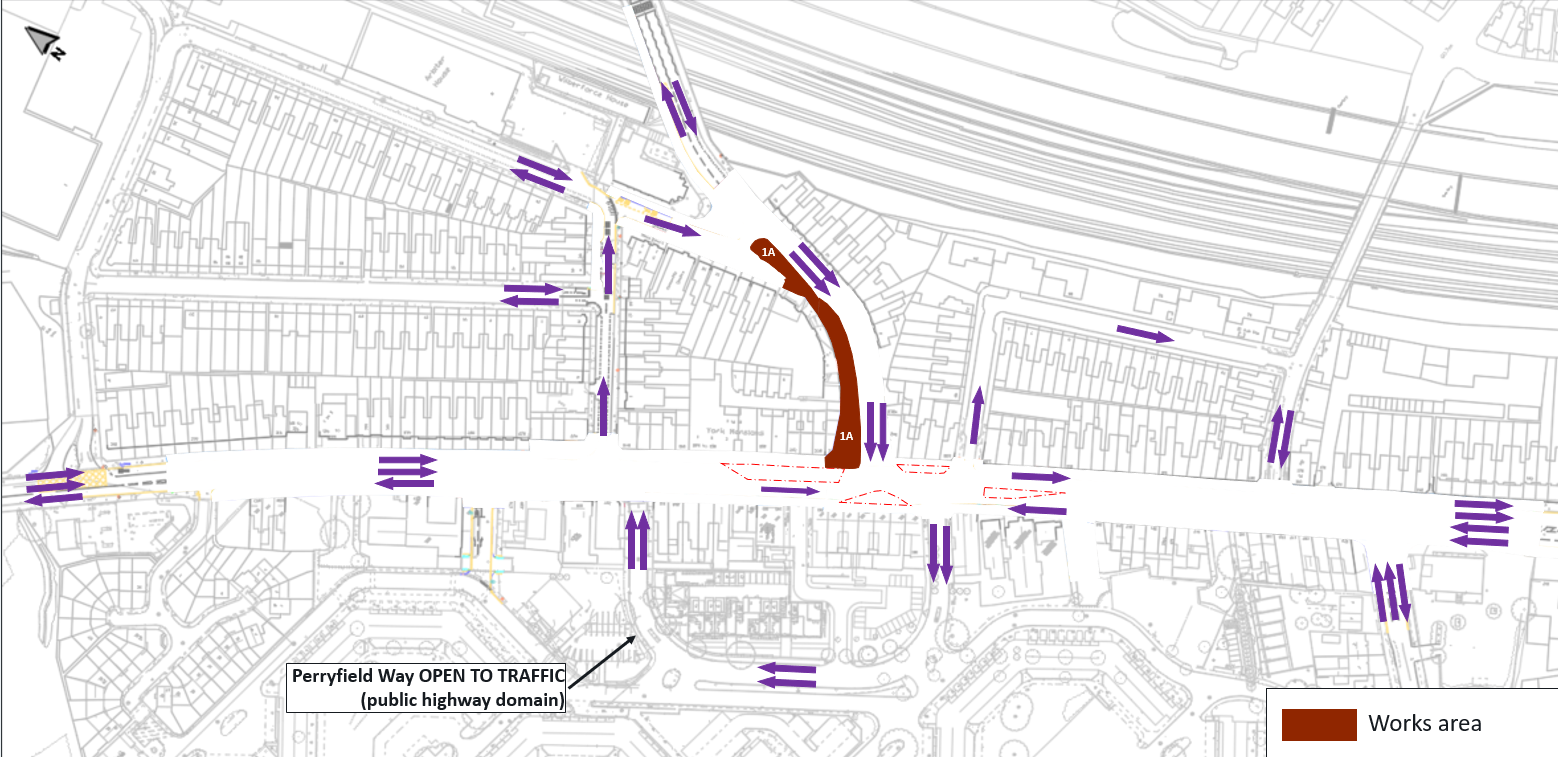

Oct 2024
Click to view full plan

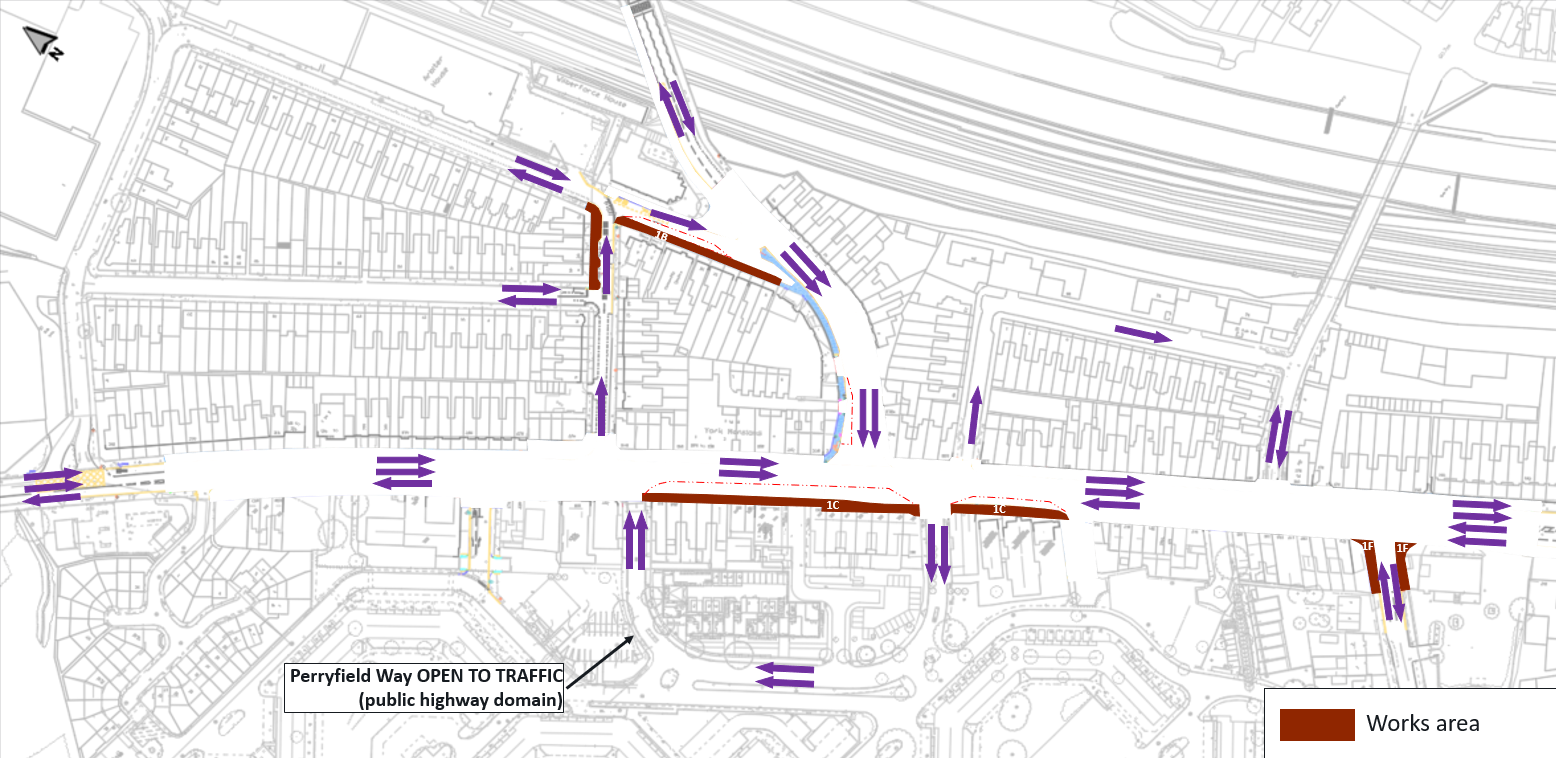

Jan 2025
Click to view full plan

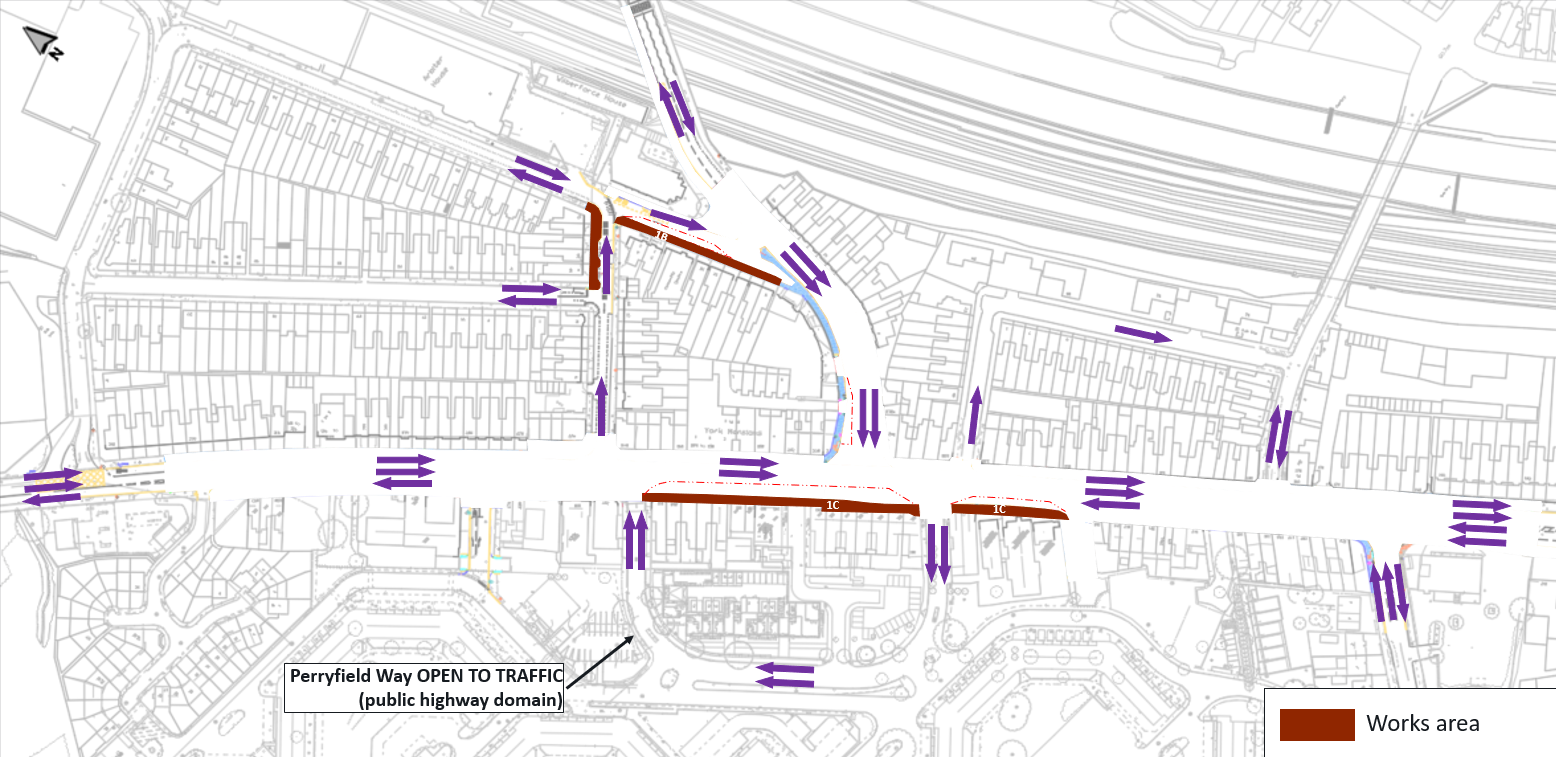

Feb 2025
Click to view full plan

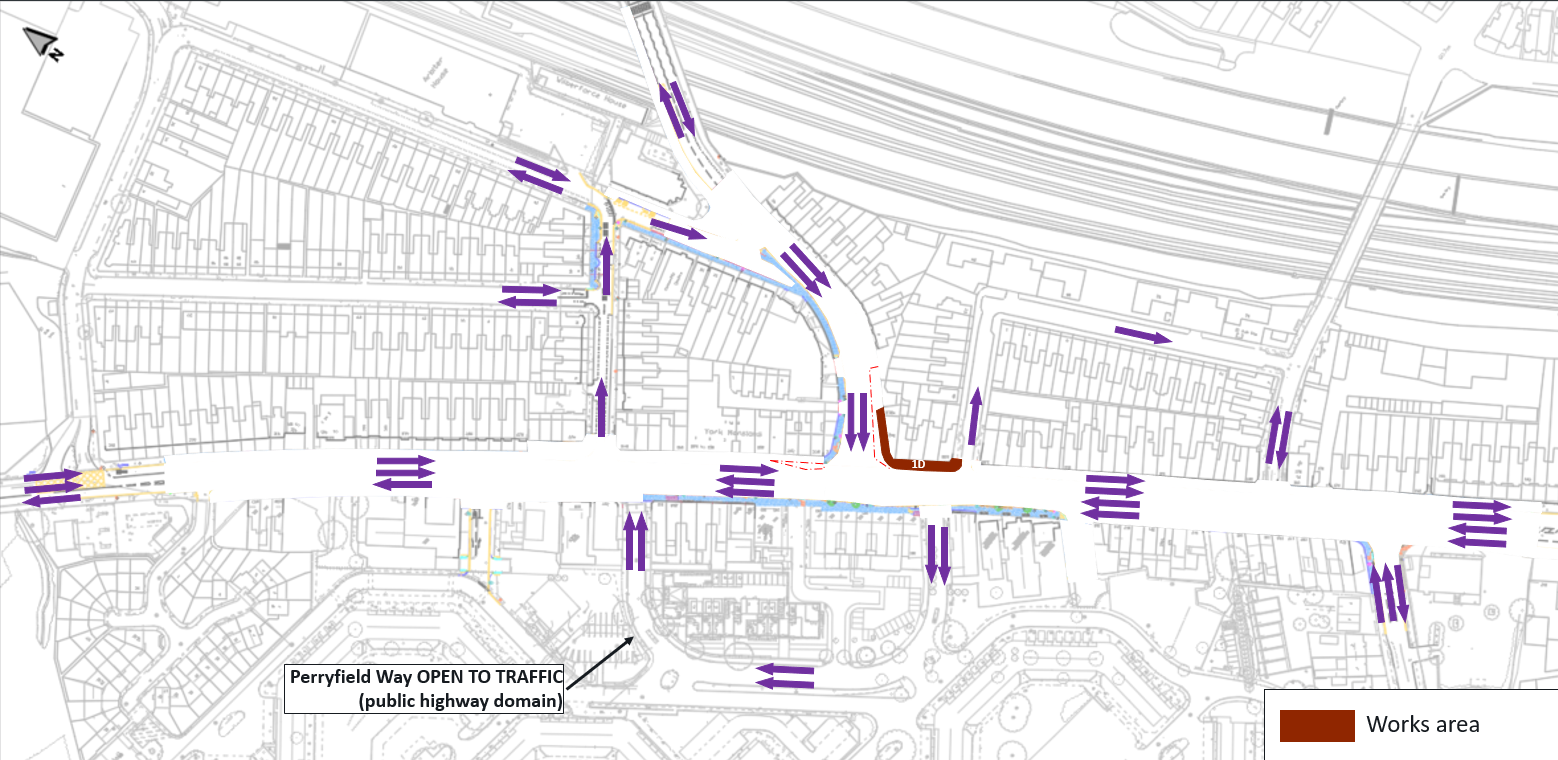

Mar 2025
Click to view full plan

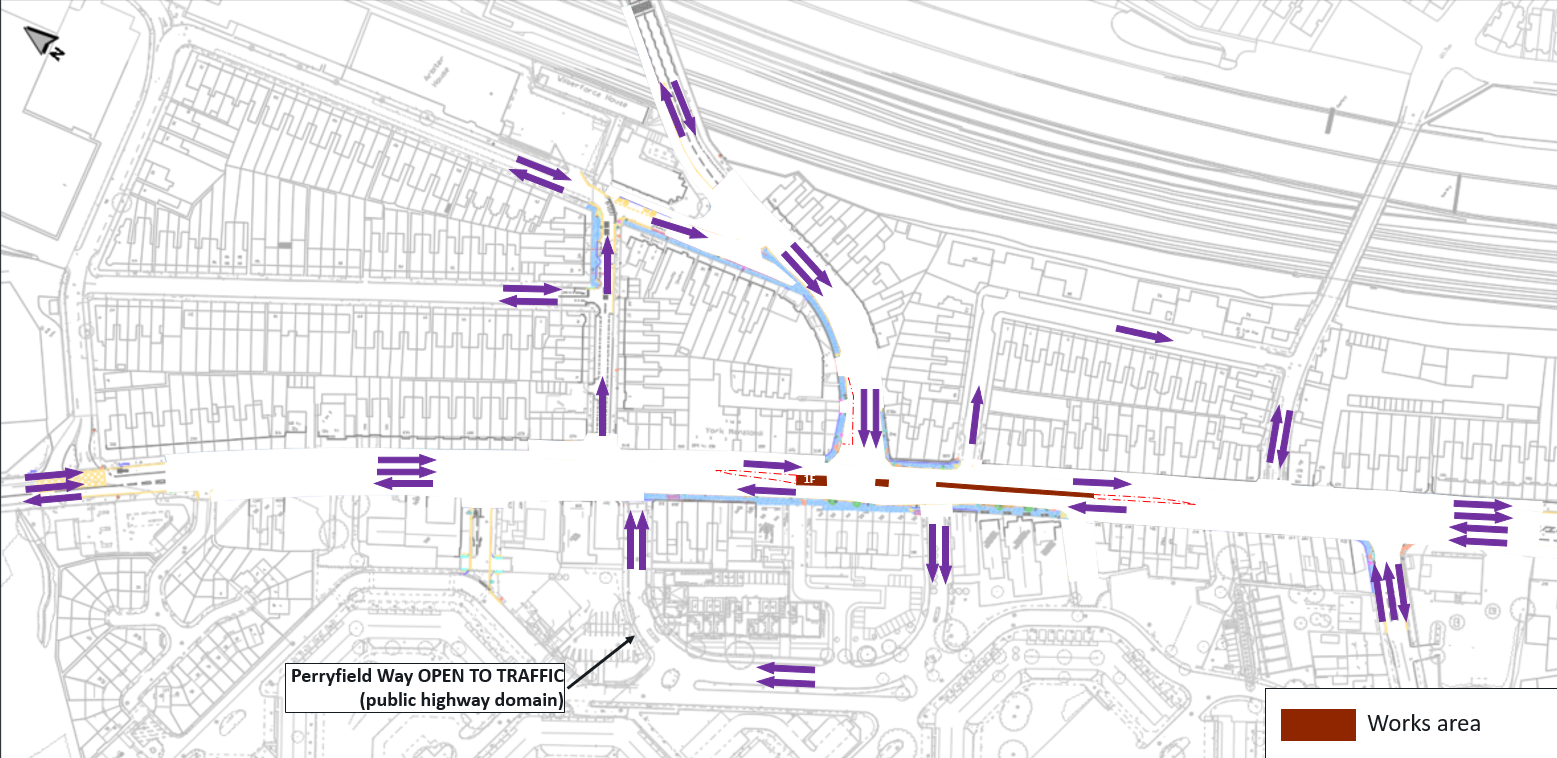

Apr 2025
Click to view full plan

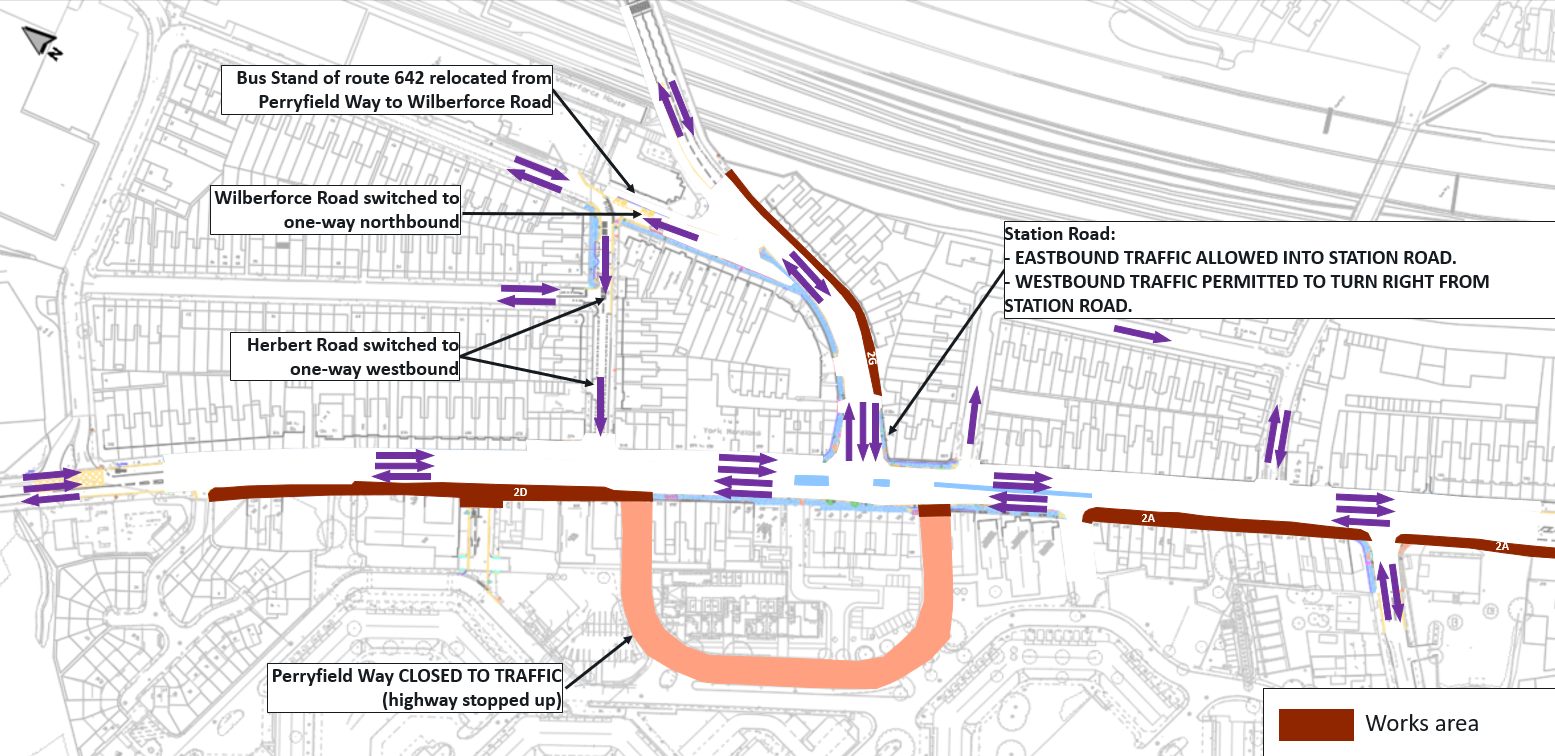

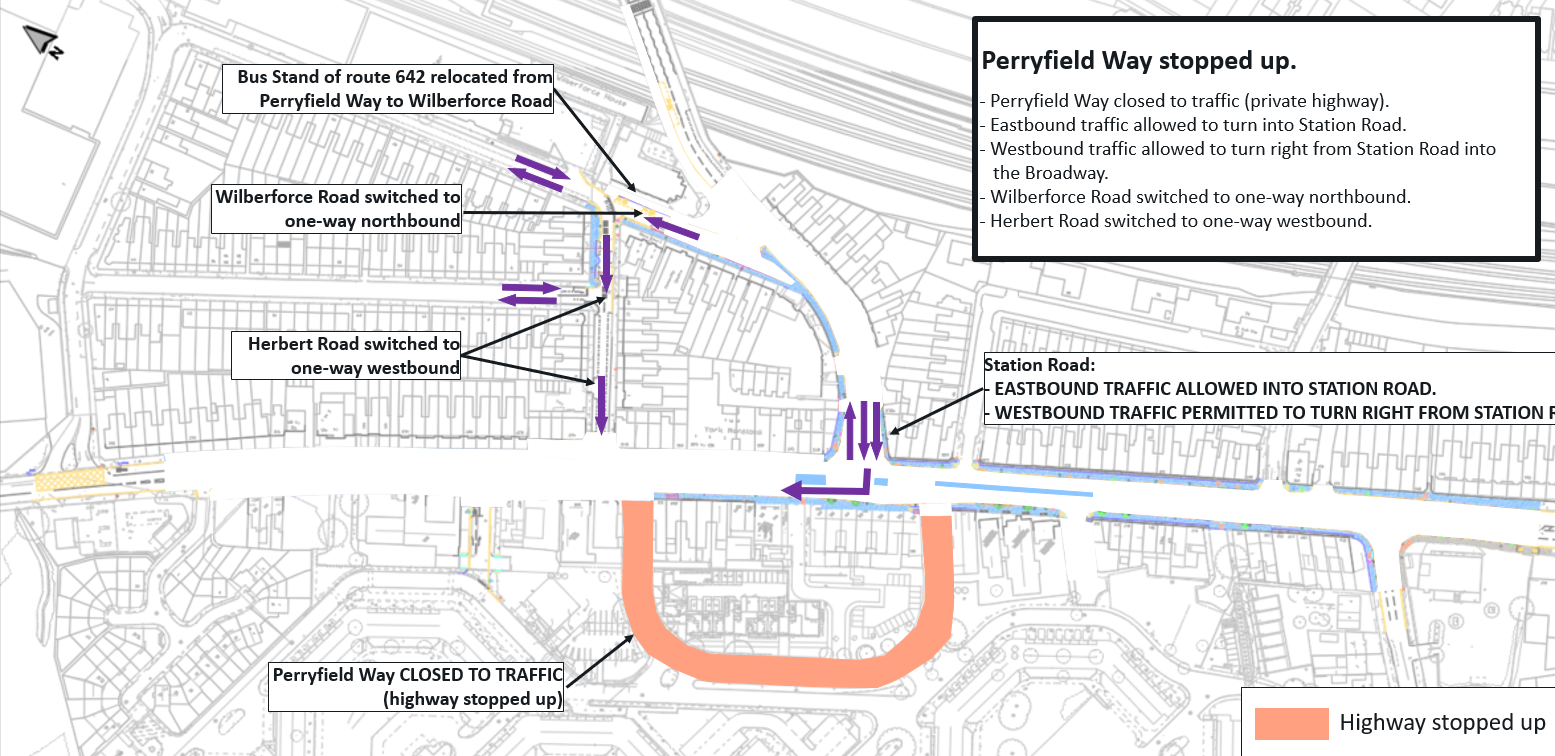

May 2025
Click to view full plan

May 2025
Click to view full plan

Jun 2025
Click to view full plan

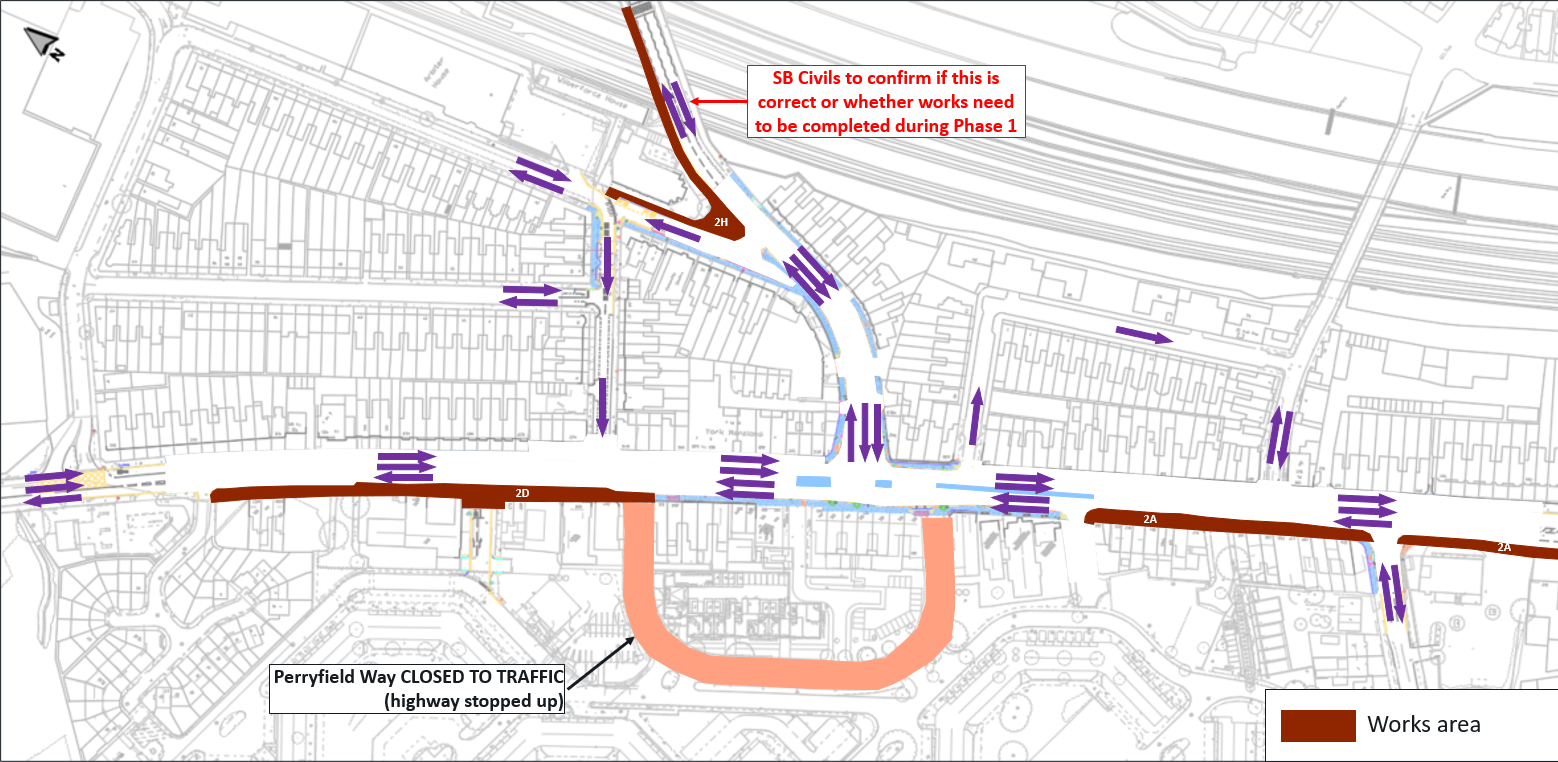

Jul 2025
Click to view full plan

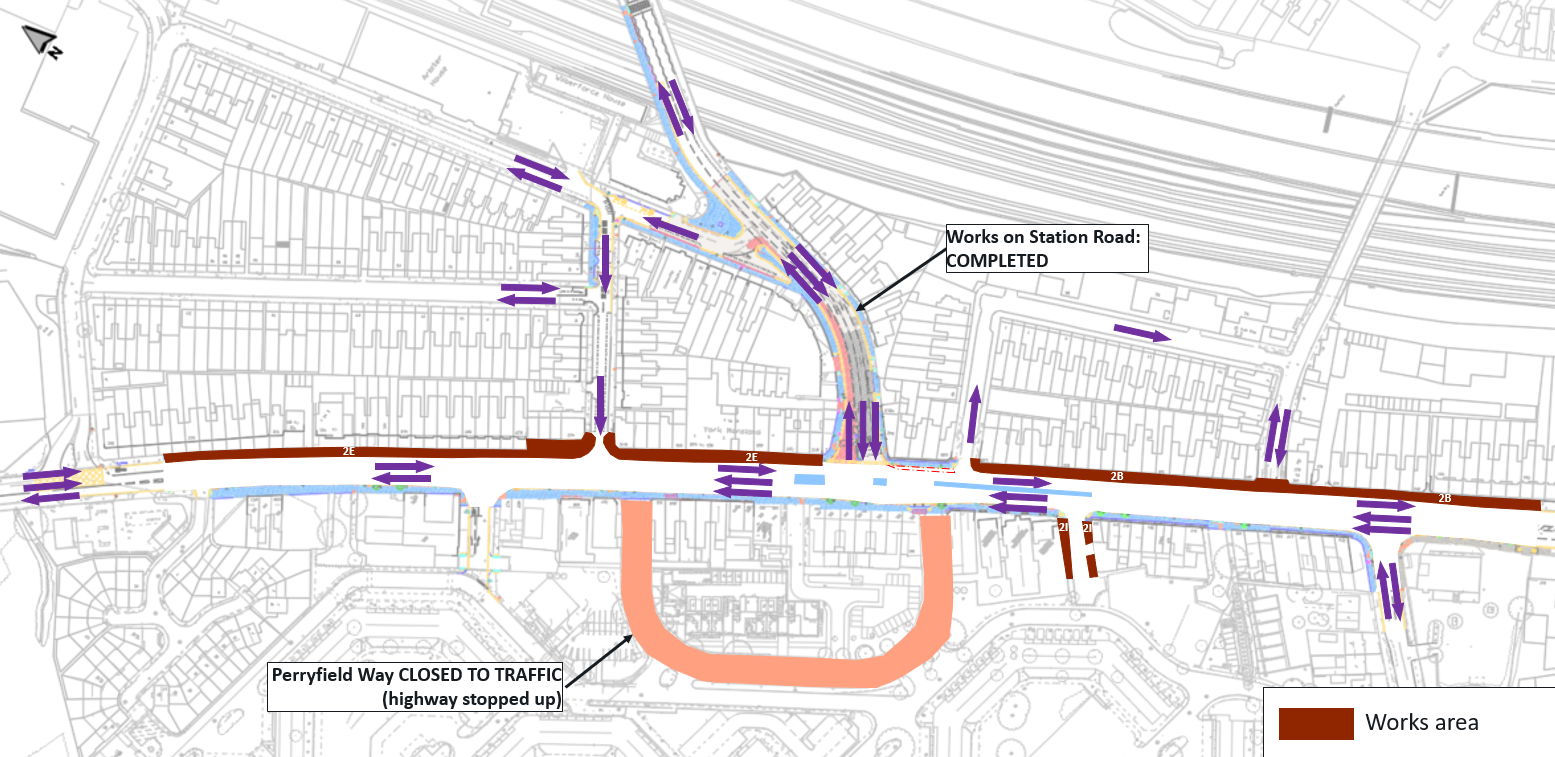

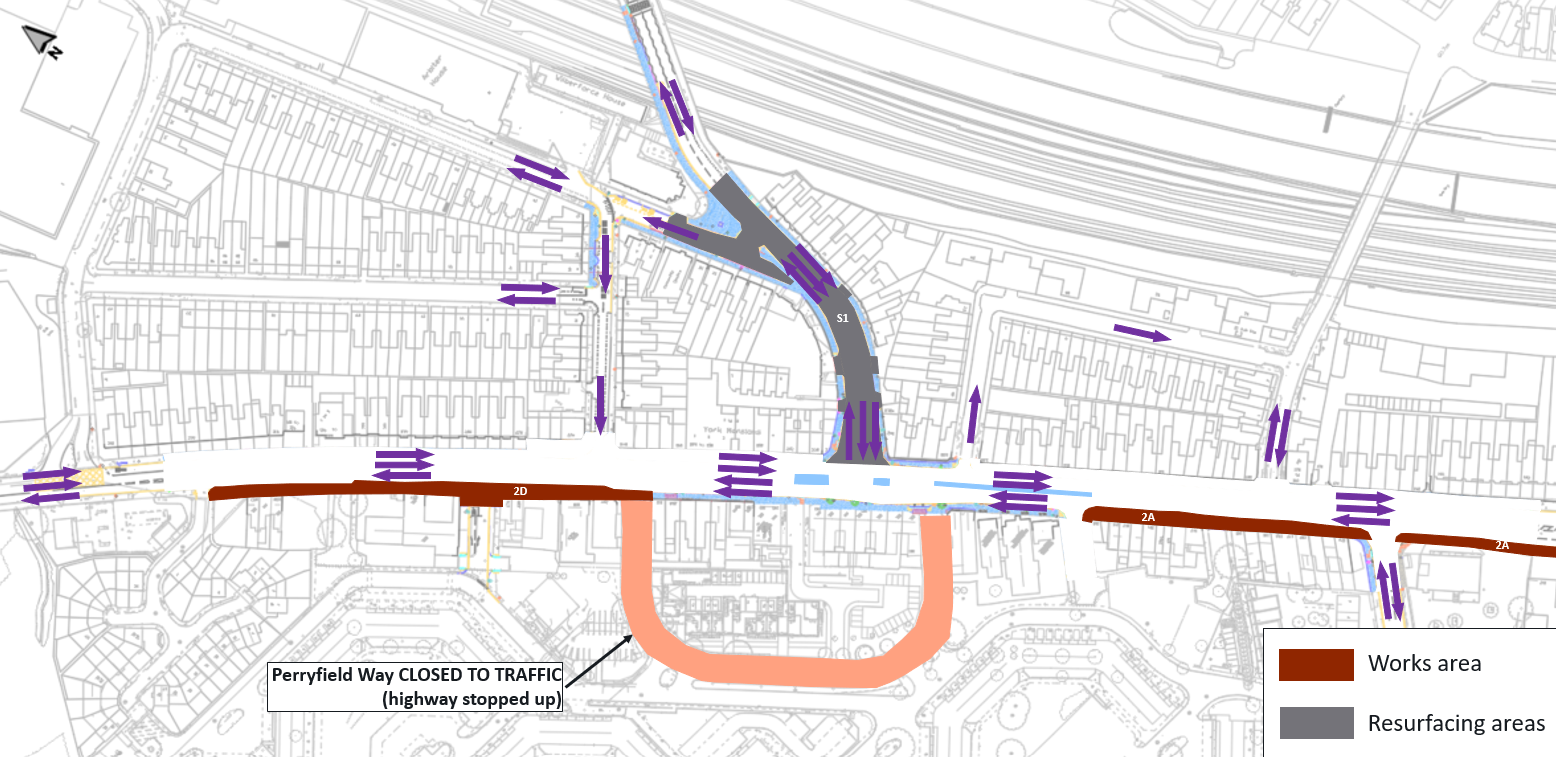

Aug 2025
Click to view full plan

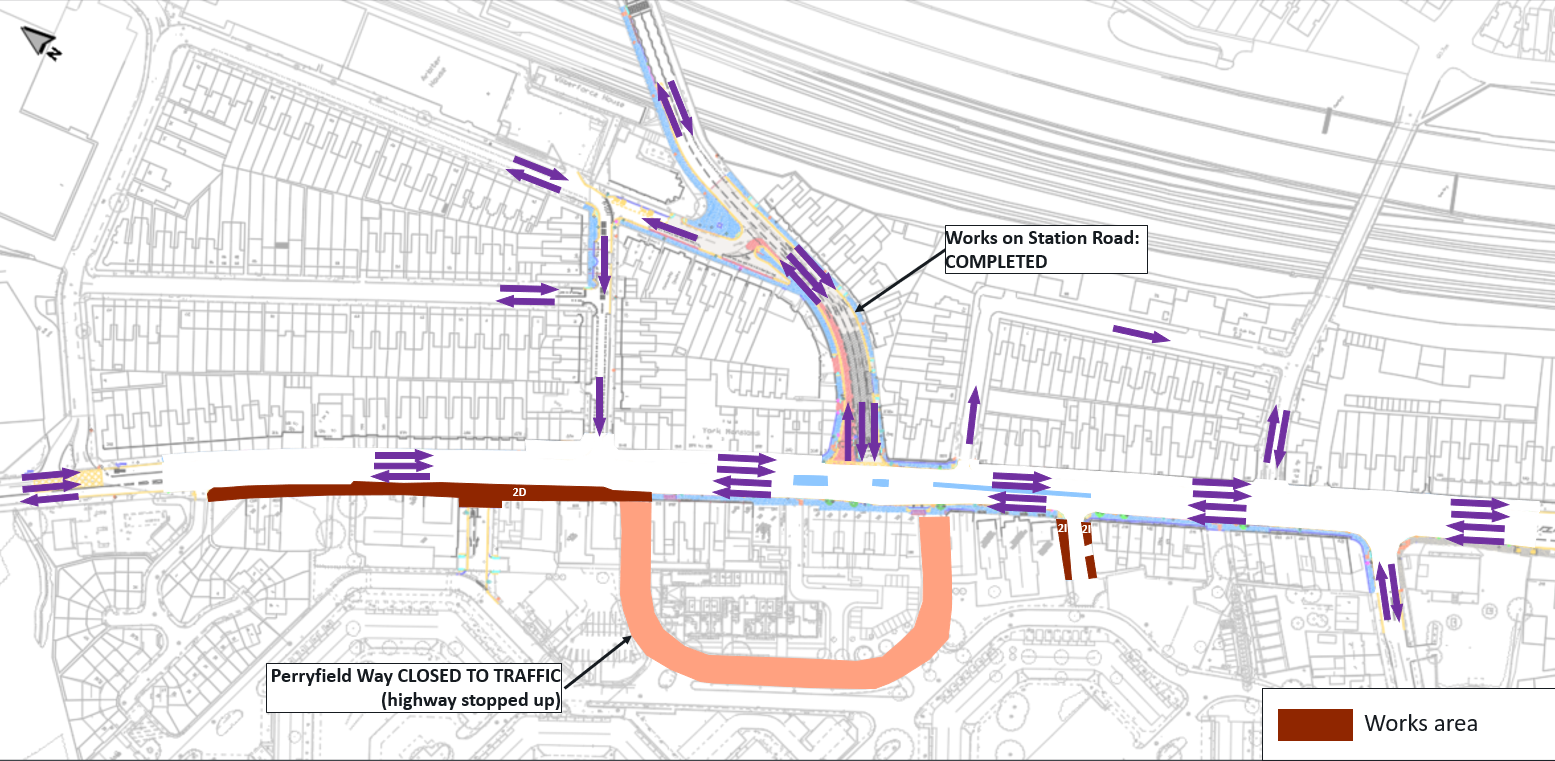

Aug 2025
Click to view full plan

Sep 2025
Click to view full plan

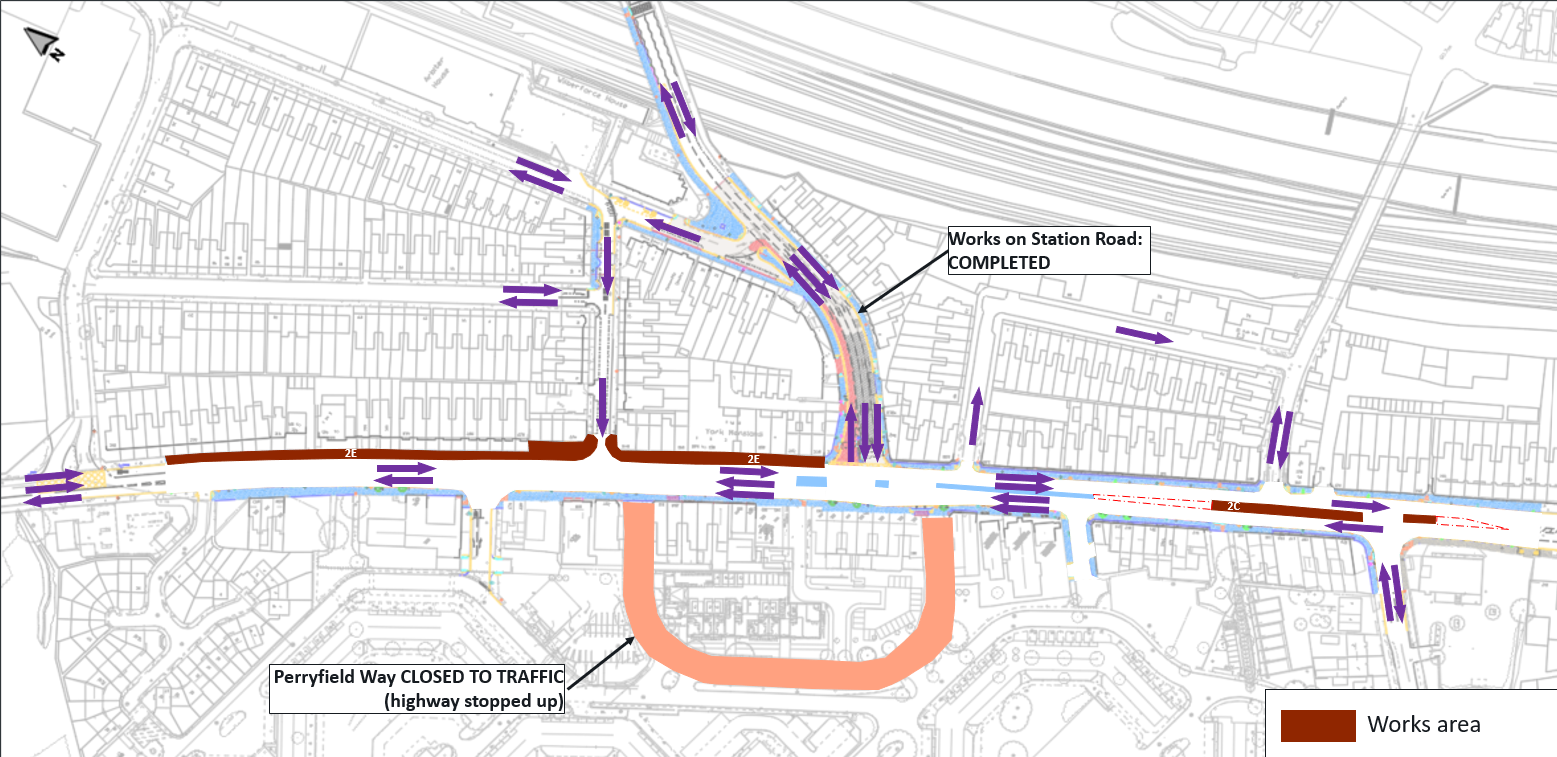

Oct 2025
Click to view full plan

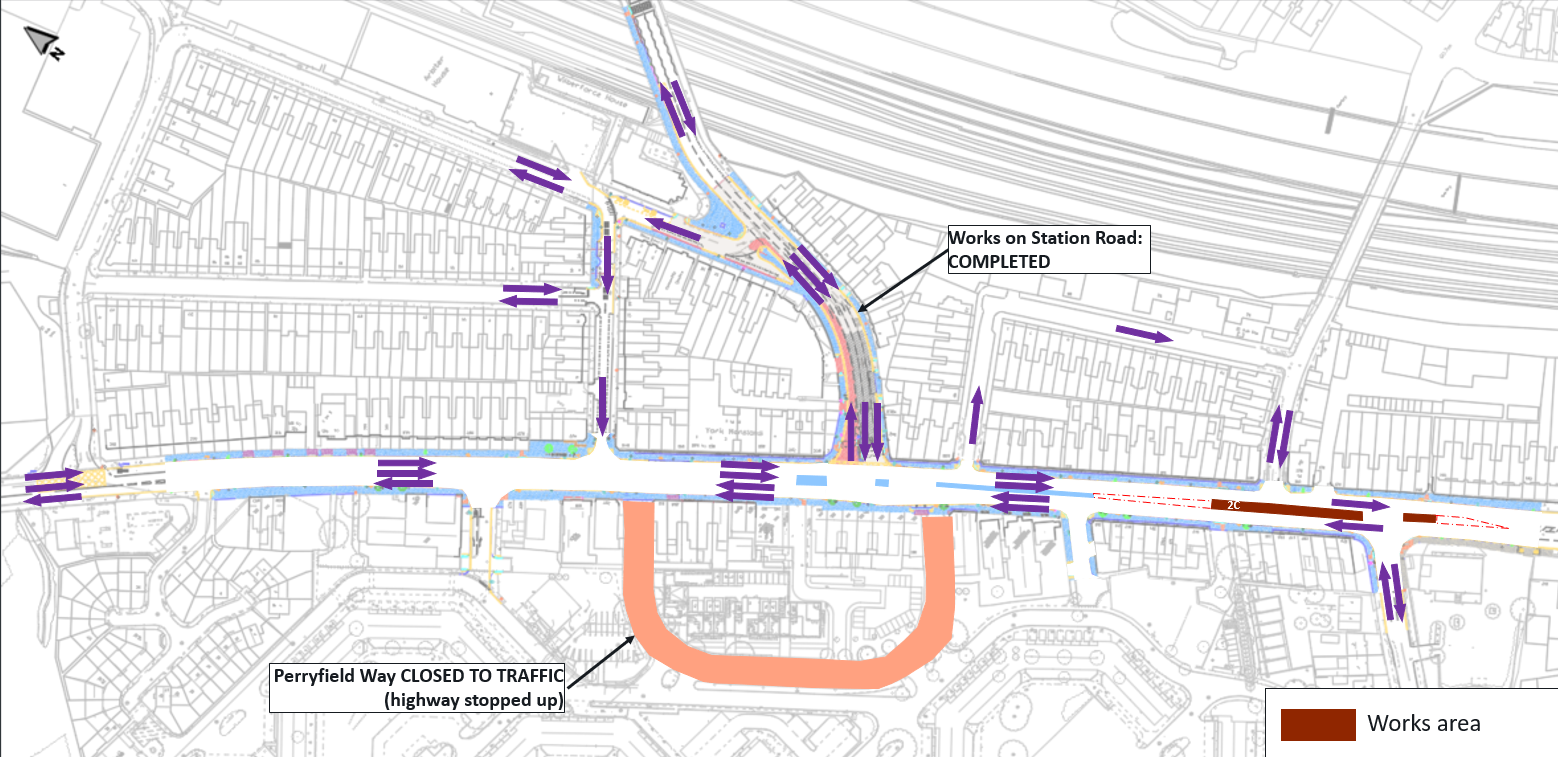

Nov 2025
Click to view full plan

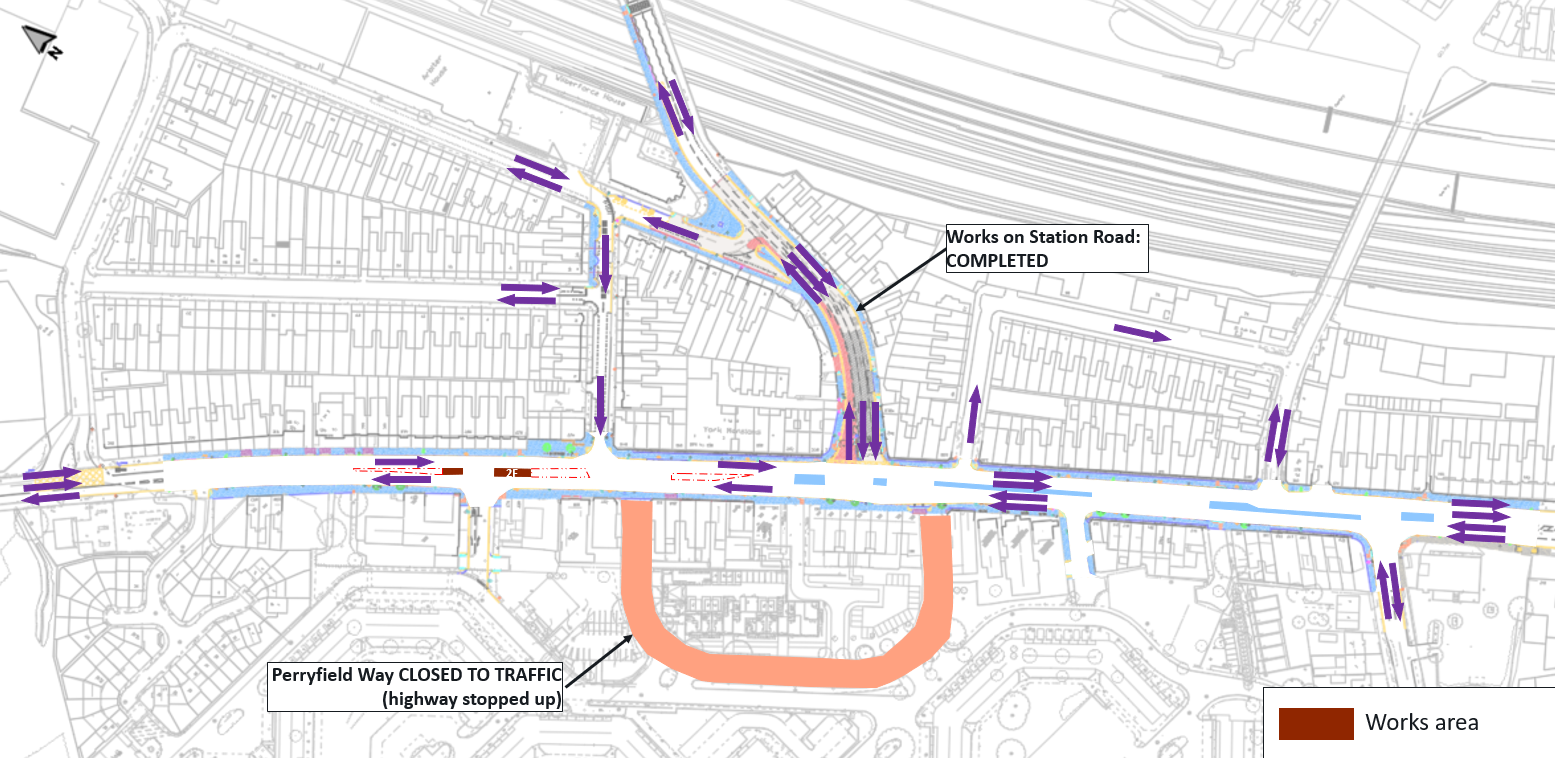

Nov 2025
Click to view full plan

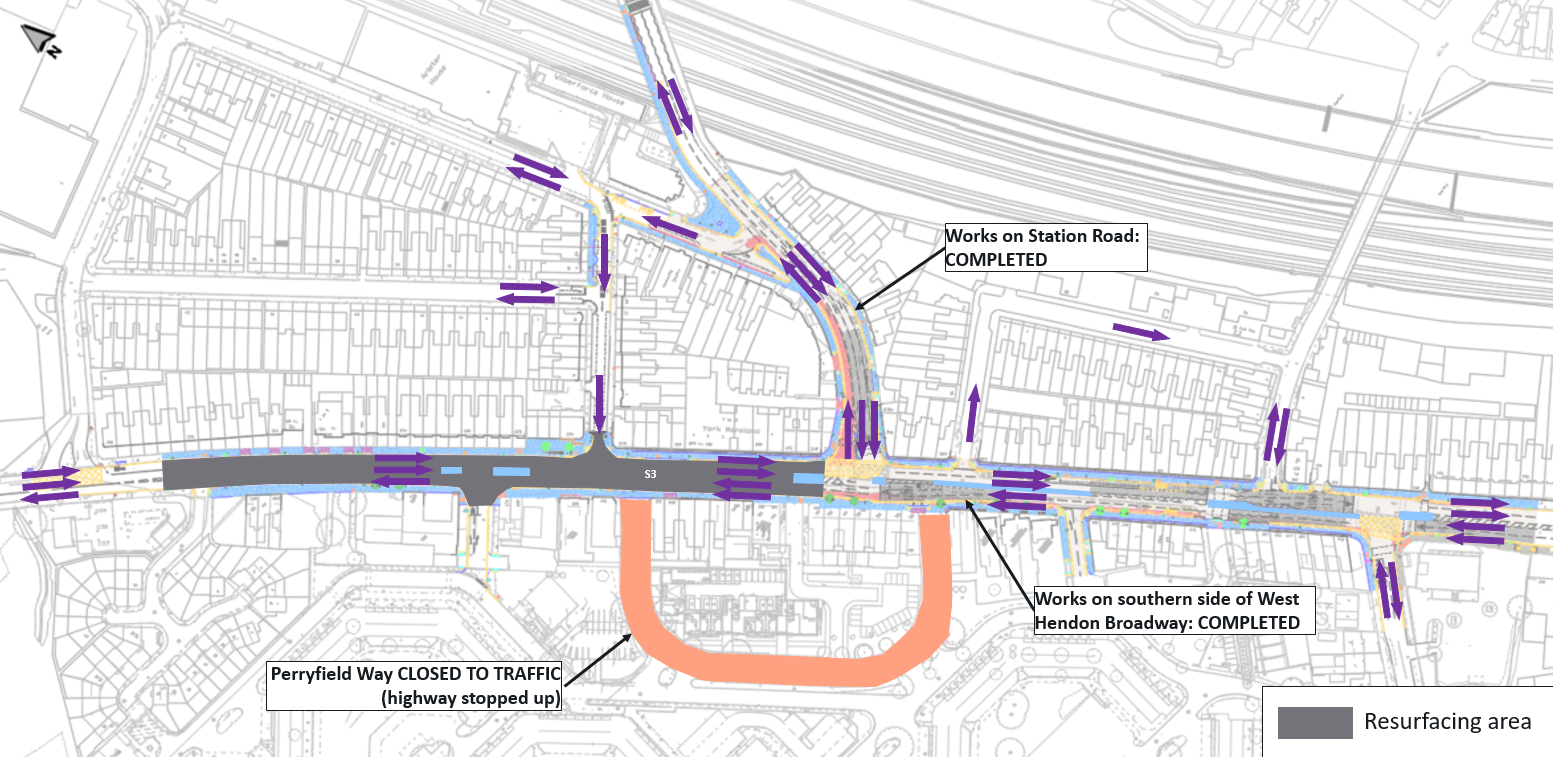

Jan 2026
Click to view full plan
Key Milestones Ahead
Important dates and developments that will shape the next phase of the project.
Traffic System Changes
Major highway reconfigurations begin, including road widening and one-way system reversals.
First Homes Groundbreaking
Construction of the first phase of new homes begins, marking a major milestone in the development.
Perryfield Way Closure
Permanent closure of Perryfield Way to through traffic, with alternative routes fully operational.
Community Center Start
Construction begins on the new community center and public facilities.
First Homes Ready
The first new homes become available for occupancy by residents.
Full Completion
All housing phases completed with community facilities and public spaces fully operational.
Stay Informed
Get the latest updates on our progress and upcoming milestones.
Current Progress
View detailed progress reports and see how construction is advancing across all phases.
View ProgressLatest News
Stay up to date with the latest developments, announcements, and community information.
Read NewsQuestions About the Timeline?
Our team is available to discuss any aspects of the delivery plan and how it might affect you or your business.
